WO post-calculation

Production > Work order general > WO structure > FA Nachkalkulation _2

Top  Previous  Next
Expand/Collapse Toggles

In this window you can set up parameters for a single post-calculation.

PATH: Production > Work Orders > Work orders list tab > right-click menu > Button "post calculation".

See WO structure.



Post_calculation

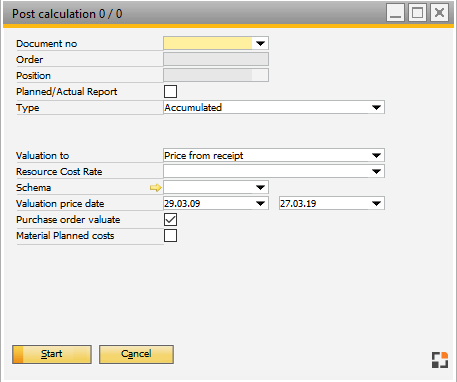

Window fert_naka_auswahl.psr



Field

Meaning

Document number

Document number of the selected work order.

Work order

Work order number.

Position

Position number.

Actual / Plan

Check mark: activates Actual/Plan – comparison.

Type

Accumulated

All costs incurred will be valued. Assembly posting will only be valued if this was enabled in the settings. By default, assembly postings do not affect the price. Special case: warehouse withdrawal. (see Valuation of assemblies)



Example:

Order-related assembly structure

(10) Assembly A

|_ (20) Assembly B

    |_ (20)/(10) Material C



In WO post-calculation costs are passed on from lower level to top levels. Assembly "A" thus contains the costs of Assembly "B" and Material "C" and of the calculation schema.



In Batch-Post-calculation only one result row is displayed (see option "accumulated, all assemblies separately calculated)

Default

The actual post-calculation value of an assembly is valued. The additional postings of the sub-assemblies are considered.

Example:

If costs arose for subassembly B , but assembly B was not yet reported as completed, these costs are not passed on to the superordinate assembly A.

One step

Only the current level is valued. Sub-assemblies are valued as material (default) or according to the setting  "value assembly". Projection function is available.



This is the default valuation method which is used to value assemblies for postings.

Accumulated, all assemblies separately calculated

Each position is calculated in several steps separately. The results of the sub-assemblies are not saved.



This option is available only in the batch-post-calculation



order related assembly structure

(10) Assembly A

|_ (20) Assembly B

    |_ (20)/(10)Material C



Calculation:



- "accumulated" for Assembly "A", which contains all costs of Assembly "B" with Material "C" and all surcharges of the calculation schema



- separately "accumulated" for Assembly "B", contains the costs of Material "C") and all surcharges of the calculation schema



Result: two rows

Result of total structure Assembly "A"

Result total structure Assembly "B"



Note:

Option is available only on Batch-Post-calculation.



See Valuation

Valuation to

Selection from valuation methods (according to configuration wizard).

Resource cost rate

Determines which cost rate to use to value resources.

Default: no entry=planned and actual values are used.

If a cost rate is selected, planned and actual values valued at the selected cost rate. See Cost rates

beas9.0-000-003-000

Schema

Used calculation schema.

Valuation price date (period)



Only costs from the selected valuation dates (period) are calculated.

Purchase order valuate

If this switch is enabled, purchase orders are considered as actual costs. (No need to wait for Purchase invoice).

Material Planned costs

Activate radio box consider material as planned costs.



Functions

Button / Menu

Meaning

Start

By clicking start, the work order is re-calculated and displayed. See: WO post-calculation – Results.

Save settings

The current settings are saved for the current user and can be re-used.

Function is only accessible via right-click.

Window settings

Access on relevant settings of the configuration wizard (except from post- calculation area). There are settings that cannot be set up per calculation. These settings apply for all users and can be accessed also via Configuration wizard > calculation > post calculation.



Click on Start to perform a final costing for the work order. The result can be viewed.



Note: Tool costs are not taken into account in post-calculation.



see

Post-calculation Concepts

WO post calculation – result

Post-calculation

Configuration wizard – Calculation – Post-calculation



back to work order structure
