Calculation Objects Edit

Administration > Setup > Precalculation > Calculation schema > Calculation objects > Calculation Objects Edit

Top  Previous  Next
Expand/Collapse Toggles

This chapter is set to describe the different calculation objects in Beas.



In this window you can edit a calculation object of a calculation schema.

Only the fields available for this will be displayed depending on diverse settings if a calculation object is edited.



PATH: Administration > Setup > Precalculation > Calculation Schema > Edit schema > "Overhead Costs" tab > Open an entry.

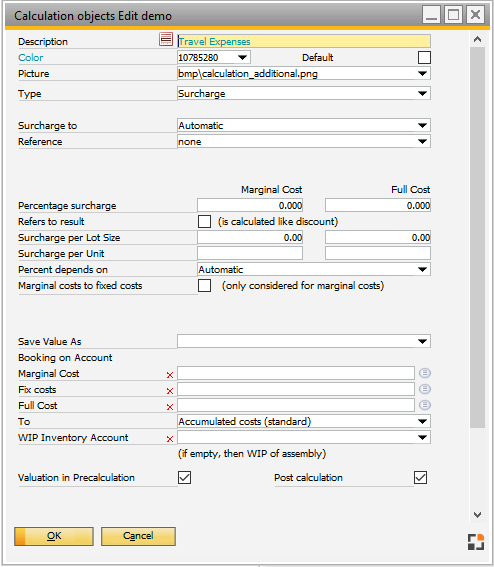

Calculation_object_edit_SAPStyle

Window pk_typen_edit



Note: The calculation schema will always be copied from Administration > Setup at a post-calculation. Changes made in the Precalculation will not be considered in the post-calculation.

Type

Description

Description

Description

Color

Objects of different areas have the following colors



Light blue: defined calculation objects (RGB 10785280)

Red: Subtotal of the above objects (RGB 4793544)
Blue: Sales price and revenue (RGB 11941650)



Colors can be adapted individually.


This image is used to represent the object in all lists

Type

Type

Description

Surcharge

Surcharge object: arbitrary surcharge as value or per cent or cost type

see cost element

Material sum

Pure sum field: represents the material costs including outsourced operation costs.

Production sum

Pure sum field: Represents the sum of manufacturing costs

L + M costs

Pure sum field: sum of all material, production and surcharge costs calculated up to this position

Sales price acc. to entry

Represents the sales price. Option "Sales price according to default": if you don´t enter a sales price, the calculated gross full costs or gross marginal costs are used.

Margin amount

Represents the margin

Margin %

Represents the margin in %

Margin (hr)

Represents the margin per hour

Material costs without outsourced operation

Pure sum field: represents the material costs without outsourced operation costs.

Cost of External Operation

Pure sum field: represents the external operation costs

Surcharge to

Charge to" can only be configured in the "Total Cost Field" object type

Type

Description

Material Costs

Charge to material costs

Non Material Mfg Cost

Charge to manufacturing costs

Production Cost

Charge to production costs

Cost of Sales

Charge to cost of sales

Net Sales Price

Charge to net sales price

Gross Sales Price

Charge to gross sales price

Price from Offer

Charge to price from offer

Basic Material Costs

Charge to source material costs

Automatic

Automatic calculation (preferred setting)

Reference

"Reference" can only be configured in the "Total Cost Field" object type

Type

Description

Loading for material

Material surcharge costs (surcharges are defined in the material group of the material).

Cost of tools

Tool costs (currently can only be determined via cost element) – see Tool.

No

Manual input of surcharges as amount and / or percent at marginal and full costs.

Material price as per BOM

Material costs without external operation costs.

Non Material Mfg Cost for WO Stat.

Non Material Manufacturing Cost.

cost of External Operation

Cost of External Operation.

Net weight

Weight surcharge calculation at net weight (does not currently work).

Gross weight

Weight surcharge calculation at gross weight (does not currently work).

Calculated Shipping Costs

Shipping cost calculation (does not currently work)

Cost element

Sum of the cost element to be defined here. This can be used to perform an analysis for setup, processing, tool costs, wage costs, etc.)

see cost elements, tool costs.

Cost element surcharge

Surcharge sum of the cost element to be defined here. The surcharges are defined in Master data > Cost element .

Cost element group

Sum of cost element group (sum of all cost elements in this group).

Cost group surcharge

Sum of cost element group (sum of all cost elements in this group).

Script

surcharge is calculated with a script. A script management is available, which can be called up via selection feature in this field See Scripting.

Cost element

For reference "Cost element" and "Cost element surcharge" only - Determines which cost element sum should be considered.

Time requirement display

For reference "Cost element" only - should the time requirement planned for this cost element be displayed in the calculation (visually only)

Cost element group

For reference "Cost element group" and "Cost element group surcharge" only – determines which cost element group sum should be considered.

Script

For reference "Script" – Determines, which script to use for surcharge calculation. See Scripting, Scripting Precalculation, Scripting Post-calculation

% Surcharge

Only visible for reference "None": determines the percentage value of the surcharge at marginal and full costs

Surcharge per lot size

Precalculation

Value refers to lot size of the item to be calculated. If the item has no lot size, the calculation lot size applies.



Example:

Lot size: 10

Surcharge per: 5€ (in this case per 10)

View per: 100

Displayed: 50€ for 100



Production Price calculation

Lot size depends on valuation method

Example: Price per Lot size = 100€, Work order: 10 Pcs

Calculation for plan costs: Projection is always on



Example: Receipt same quantity as planned

Receipt Qty

Close

Projection off

Sum (*1)

Projection On (*2)

Sum *1)

2


100€

100€

Lot size price 100€ / 10 Total Qty * 2 Receipt Qty) = 20€

20€

3


0

100€

30€

50€

5

x

0

100€

100€ - previous total (50 € ) = 50€

100€

(*1) Valuation type Post calculation: The system calculate always the complete sum (Accumulated) and divide at end all previous costs
(*2) Valuation type Plan calculation: Always use "Projection on". Always calculate per receipt quantity.



Example: Receipt less than planned

Receipt Qty

Close

Projection off

Sum (*1)

Projection On (*2)

Sum *1)

2


100€

100€

Lot size price 100€ / 10 Total Qty * 2 Receipt Qty) = 20€

20€

3


0

100€

30€

50€

1

x

0

100€

100€ - previous total (50 € ) = 50€

100€



Example: Receipt more than planned

Receipt Qty

Close

Projection off

Sum (*1)

Projection On (*2)

Sum *1)

2


100€

100€

Lot size price 100€ / 10 Total Qty * 2 Receipt Qty) = 20€

20€

3


0

100€

30€

50€

10

x

0

100€

100€ - previous total (50 € ) = 50€

100€



Surcharge per unit

This is to define surcharge per unit.





Precalculation

Lot size given in Precalculation



Production post-calculation

Planned value: quantity as per manufacturing position quantity in warehouse units
Actual value: total posted quantity





Assembly valuation

Partial posting / Calculation object: quantity to be posted in

Partial posting / Summation: already posted + quantity to be posted in



Final posting / Calculation object: quantity to be posted in
Final posting / Summation: already posted + quantity to be posted in



Note on valuation at planned costs:

Only the posted quantity is valued, not the planned quantity.

At final valuation (upon closing the work order) the total planned quantity is taken as reference.



Example 1:



Surcharge per unit: 5 €

1. Partial posting 2 pieces:  10€ on object, 10€ in sum

2. Partial posting 2 pieces:  10€ on object, 20€ in sum



Because an account can be stored in calculation object, it is mandatory to calculate costs for posting.



Example 2: Calculation at post-calculation price



Referring to example 1 costs are booked to the the given account

1. partial posting 2 pcs = 2*5 = 10€
2. partial posting 2 pcs = 2*5 = 10€



Calculation of L+M costs:

1. partial posting 2 pcs = 2*5 = 10€

2. partial posting 2 pcs = 4*5 = 20€
   Less the already posted 10€ = 10€



Even if the calculation type is different, the result is the same.

Percentage value relates to

only visible for reference "None". Defines the sum to which the percentage value refers

Automatic

Refers to the last sum, if no intermediate sum is there, as reference serves the first entry, which returns a value

Price of material as per BOM

Refers to the material sum

Non Material Mfg Cost for WO Stat.

Refers to the manufacturing costs

cost of External Operation

Refers to the external operation costs

Material costs + external operation costs

Refers to the sum of the material costs and external operation costs

Save value as

The costing analysis includes 6 user-definable fields in which the calculated costs can be saved.

This makes it easier to further utilize the costing analysis.



The following values are fixed:

Material surcharge

Production surcharge

(Values saved here are user-definable)



4 further fields can be defined in the Configuration Wizard.

The values stored there can be retrieved directly in the results list in the costing analysis (e.g. wage costs, tool costs, machinery costs)

Booking on account (marginal costs, fixed costs, full costs)

If an account is stored here and in the Configuration wizard > Production > Valuation Assembly > Valuation > Post overheads for partial delivery is NOT set to "No posting" and continual inventory maintenance is activated, the accounts specified here are credited and the WIP account debited at the time indicated there.



The cost rate at marginal costs, fixed costs (= full costs - marginal costs) or full costs can be used.

To ...



Refers to the account to be debited:

Defines the amount to be posted:

Accumulated costs

The actually accumulated costs are posted (actual value)

planned costs

The planned costs as per precalculation are posted

planned for partial delivery, other accumulated

Can only be used if posting of overheads to "For assembly receipt" is activated.

For partial delivery, the planned value (target value) is posted, otherwise the accumulated costs (actual value).



Note:

The surcharge postings are made to the planned costs if an evaluation of the assembly postings are made to planned costs.

A mixture of planned-evaluation with surcharges to accumulated cost is not possible.

This means that this setting is set to "planned costs" when a posting to planned costs is made.

(beas 9.3-000)



WIP inventory account

If the amount is not posted to the WIP inventory account of the assembly to be produced, the WIP account to which postings are made can be defined here.

Option is only visible if in SAP > Administration > System Initialization > Document Setting > Per Document > "Production Order" "Component WIP Accounts" is activated.

Valuation in precalculation

If deactivated, the object is displayed in the precalculation but not valued.

Valuation in costing analysis

If deactivated, the object is NOT displayed in the precalculation and also not valued.

Refers to result

Determines whether the % value relates to the previous sum or to the reference sum (A) or to the reference sum + addition to be calculated. (B)

(similar to calculation of discount or revenue)

Example: Switch deactivated, reference is A(100€) first sum
100 €+10% of A(10€) = 110
Example: Switch activated, reference is B(110€) second sum
99€+10% of B(€ 11) € 110 = 110

marginal costs to fixed costs

The fixed cost surcharge determined in calculation of marginal costs is added to marginal costs.

Example: The fixed cost share of the labor costs shall be added at marginal costs calculation.


Reference = manually
Surcharge per cent = 100% for marginal and full costs
Per cent refers to production costs according to the working sequence
At marginal costs to fixed costs: activate

Production costs would be 60 (marginal costs) or 80 (full costs)
At marginal costs calculation the 20 (100% full costs -100% marginal costs = the full fixed costs) are added up.

Post calculation

If this radio box is selected, this calculation object is considered in Post calculation.
