| In this window you can define which work orders are calculated (Selection tab) and how the calculation takes place (Calculation tab)     PATH: Production > Post calculation > Open calculation.

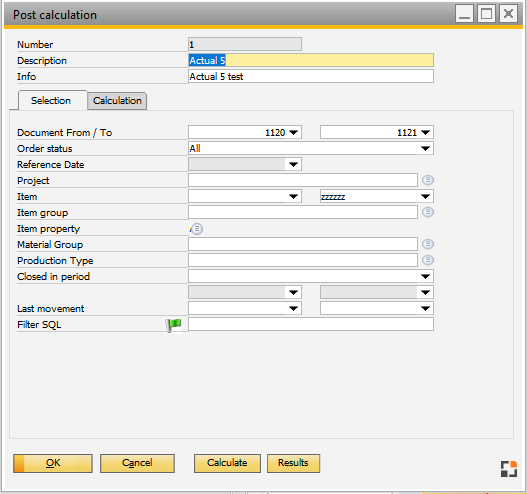

 Window postcalc_header_browse.psr   Selection tab
|  |  |
| Number | The calculation is saved with this number. |
| Description | Free text. |
| Info | Additional information. |
| Document number from to | Select for items to perform a post-calculation. If in field "from" a number is entered, this limits the field "to" (no earlier number may be entered there). |
| Order status |
| Filter all = independent of manufacturing status only open = only production items which are not completed only closed = only production items which are currently closed active on reference date = only production items which will be active by the given date (see below)  With this selection, the "type" is set to "single step" automatically. |   |
| Reference date |
|
 If this filter is set, only the following work order items are considered:  - WO items that have a document date before the given date (See Work order - Order date). - WO items that are currently active or which have been closed after the reference date   The date of completion of the work order is checked. This field can be selected only if "active on reference date" was selected at "order status".   Note:
| If a closed work order position is re-opened subsequently, the result can be falsified, because the period is not saved in which the position was opened and closed again. |
| If another type than "single step" was selected, sub-assemblies are always calculated, even if these were not active on the reference date.   Example: Pos 10 Open     Pos 20 closed, out of reference date   Running a calculation of type "standard" or "accumulated" position 20 is included in the calculation. |  |  |
| Project | Project Id (optional) (Multiple selection). |
| Item from to | For which items to perform a post-calculation. |
| Item group | Filter by item group (Multiple selection). |
| Item property | Selection for properties (Multiple selection). |
| Material group | Selection of material group (Multiple selection). |
| Production types | Selection of Production types (Multiple selection). |
| Closed in period |

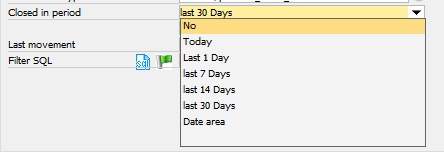

| It is possible to define a time period – today, last X days or a date area
   If Date area is selected, it is possible to insert a from–to date.   Attention:The post calculation checks only the last "close date".
 If the user reopens the work order and closes it later again, Beas ignores the first "close date".   Beas 9.3 PL 1 |  |
| Last movement | Filter: only work orders with movements in the given period. The valuation date is considered for material posting, external operation – delivery notes and for Order time receipts. |
| Filter SQL |
| Here you can define an own filter with an SQL statement. If you click on the SQL icon, you can define this in a simple way in the sql editor. The flag displays if the SQL statement is correct or incorrect: red = wrong, green = correct.   The following tables are available: Work order header: BEAS_FTHAUPTWork order position: BEAS_FTPOS
 Item: OITM
   The command must start with "and"-
 Example: Only work orders with the word "red" in field "UDF1"    and "BEAS_FTPOS"."UDF1" = 'red'   Beas 9.3 PL: 01 |  |   Calculation tab
|  |  |
| Type | Type of calculation. See WO post calculation - Type. |
| Value sub-assemblies | Determines the valuing of sub-assemblies See Configuration wizard - post calculation - assembly . |
| Valuate by | Defines the value at which the material postings are valued. See Pricing-Types. |
| Resource cost rate | Defines which cost rate to use for resource valuation Standard: no entry, planned and actual values are used. If a cost rate is selected, planned and actual values are valued at this cost rate. See Cost rates. |
| Schema | Selected calculation schema (from Precalculation). All settings are transferred (e.g. cost types, surcharges etc.).  |
| Valuation period | The valuation period can be set for long-running projects. Only the costs occurred in the specified period are calculated.
 Warning: If this function is used, a plan-actual comparison is no longer useful. If "Plan=Actual if no time receipt" is active in the options, this will lead to false results. |
| Purchase order valuate | If this switch is enabled, purchase orders are considered as actual costs. (No need to wait for Purchase invoice). |   Functions
|  |  |
| Calculate | This button runs the calculation. As it is not performed in the background, it may take long depending on the number of work orders.
| Post-calculation can be run automatically, for example once a week, at night etc. See tasks.   Call up via Beas-script object=ue_fert_naka=batchnaka=x x = Number of post-calculation   Example beas.exe user=serveruser pw=xyz /db=trainingdb object=ue_fert_naka=batchnaka=3<cr_lf>app=close |  |     back to post-calculation Help URL: https://help.beascloud.com/beas202204/index.html?postcalculation_master.htm
 |
