Gantt DisplayProduction > Capacity Planning, APS > Graphic View > Gantt Display |
Top
Previous
Next
|
A production order is displayed in the graphical view from left to right. You can switch to the "Boyum new Style" view in the View settings.
IMPORTANT: To use the Gantt graphical display for APS scheduling, you must also install the 32-bit version of Beas Manufacturing, as this third-party provider does not support 64-bit version software products.
The production order receives a totals bar (first gray bar at the top edge). The individual assemblies in turn have their own bar (bar below this).
The individual work sequences are linked together by an arrow and represent the processing sequence in the time chart. The delivery date is indicated by a red dot.

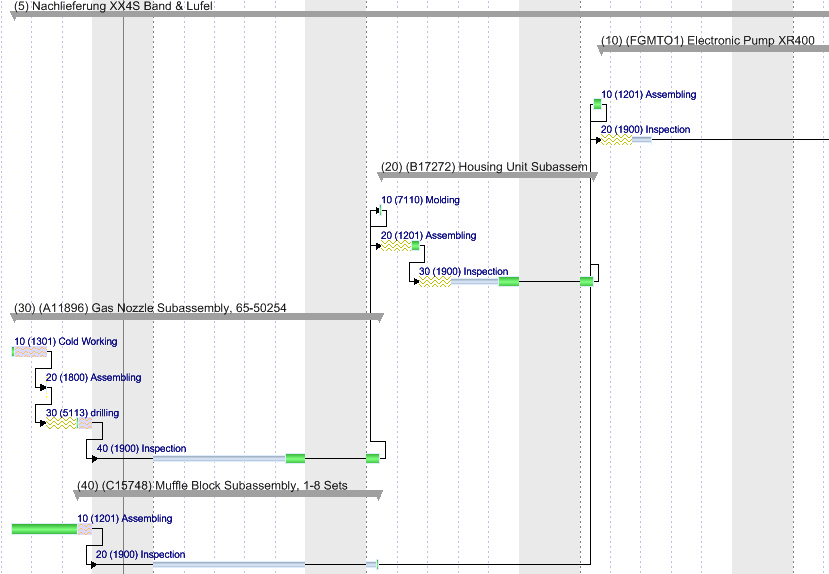

Example: Throughput of a production order
Structure of a work sequence The timeline of a work sequence is subdivided into three parts: 1. Transfer time, which is stored in days in the resource 2. The job time, based on set-up time and job time x number of units as per work sequence 3. The idle time as per work sequence.
In the graphical view, there are other symbols or color displays that indicate e.g. the status of the production order.
Icon changes: Green/Red flag: Within/past the delivery date.
|
