Scrap of Material

Concepts > Scrap > Scrap of Material

Top  Previous  Next
Expand/Collapse Toggles

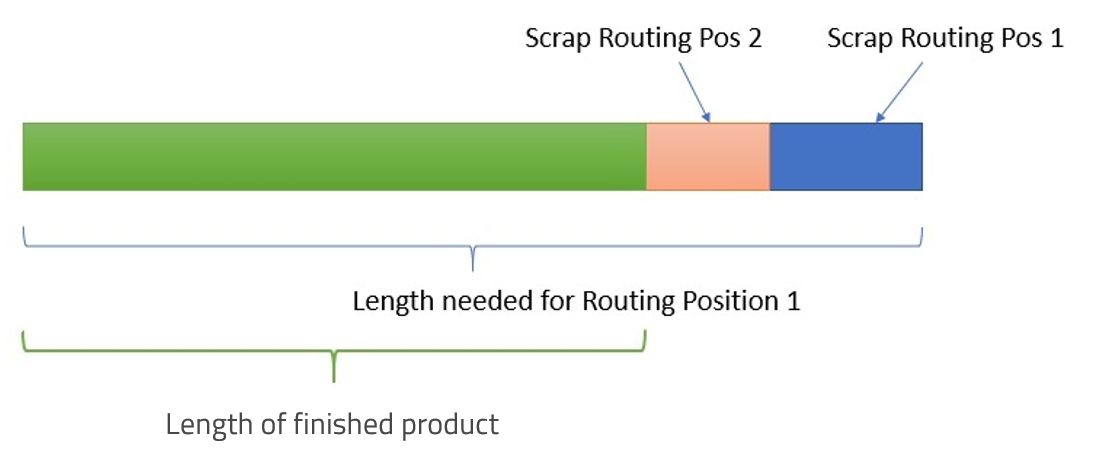

In Routing position > Extended you can define the Scrap of Material related to a routing position.



Example:

You must produce and fill 6 kg of paste.

15% is lost during filling.

Now you must calculate how many liters of paste are needed.



Calculation

Correct formula is: Quantity: (100  – Scrap % )  * 100



If you need 6 kg of finished product, you need

6 kg : (100 -  (0.15) * 100 = 7.059 kg paste



If you see the opposite:

I fill 7.059 kg paste and lose 15% =

7.059 - (7.059 / 100 * 15) = 6 kg



In the Configuration wizard > "Behavior for Routing Scrap of Material % affects" you can define how the program should work.

The "Exceeding planned quantity allowed" affects BoM position - material scrap: The Minimum/Maximum percentage is calculated based on total quantity. see Configuration setting.





The following settings are available:

hmtoggle_plus1Only the linked material is affected by the Scrap % setting
hmtoggle_plus1All materials under the last linked materials are affected
hmtoggle_plus1All materials are affected by the Scrap % setting



Notes:

This field is only visible when the parameter in Configuration wizard > Master data > routing > "operation related material scrap" is enabled.

The Item Report – Item Structure report does not support Material Scrap factor on Routing Level.

Enable this option only if absolutely necessary; the computation will take considerably longer.

In Work orders this field is blocked, because scrap of material is determined only at the moment of creating the work order.

When checking which routing positions are considered, the following criteria apply:
- Validity date
- Active (no formula, no quantity check)
- Variants (A–Z)
Not checked:
- Variants formulas, Product configurations


Help URL: https://help.beascloud.com/beas202506/index.html?conceptscrapofmaterial.htm
