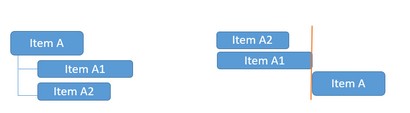

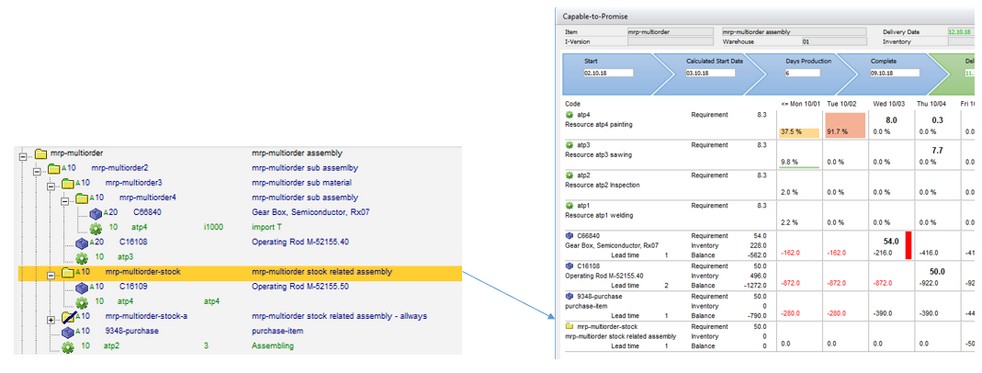

Multi-level breakdown
All BOM items and routing items are taken into account. If a BOM item is order-related or "always explode" is stored there, it is exploded further. If the BOM item is a warehouse-related assembly, no further explosion takes place.
Article version control and variant A-Z are taken into account. Lot sizes stored in the article are not taken into account.

Forward Calculation
Forward scheduling with consideration of existing production orders (in production, planned orders etc.) is used. It is not planned to infinity (= CTP). Forecast or existing sales orders are not taken into account here (MRP2).
The original APS forward scheduling is used. The default settings not changeable. It always uses forward calculation.
The default is the routing. All stored rules and optimization functions are considered, including parallel tools and resources and resource optimization.
Sub-assemblies are expanded first. Only when all sub-assemblies have been completed can the assembly above them be started.

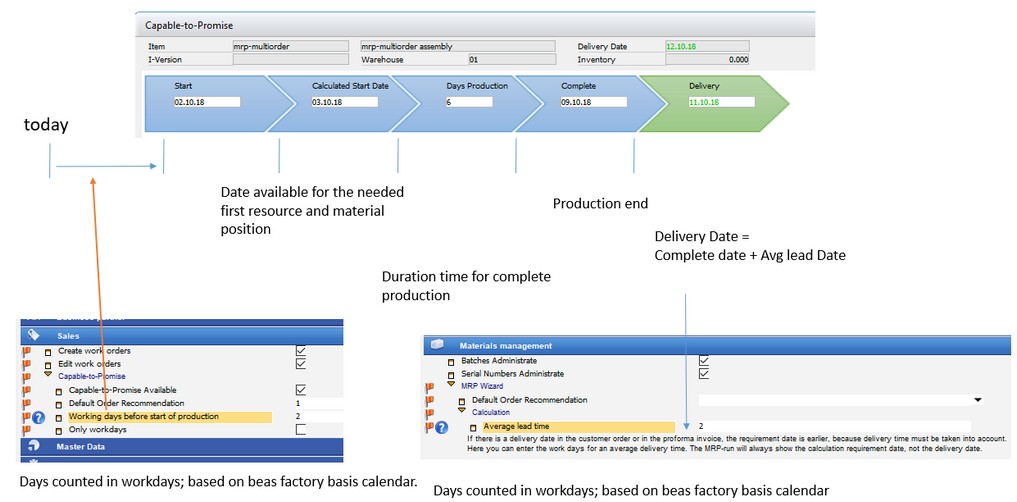

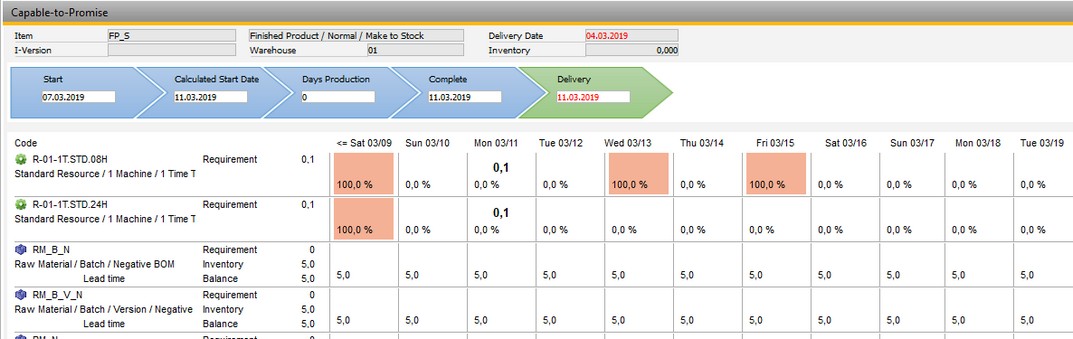

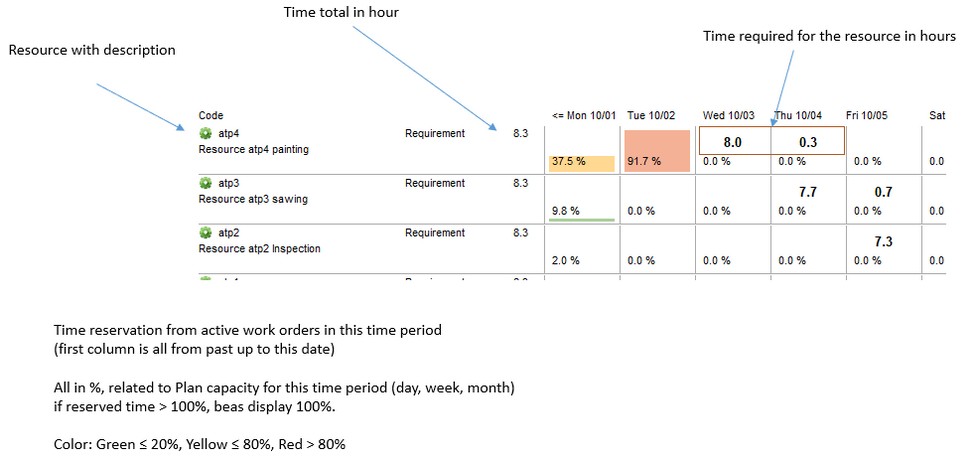

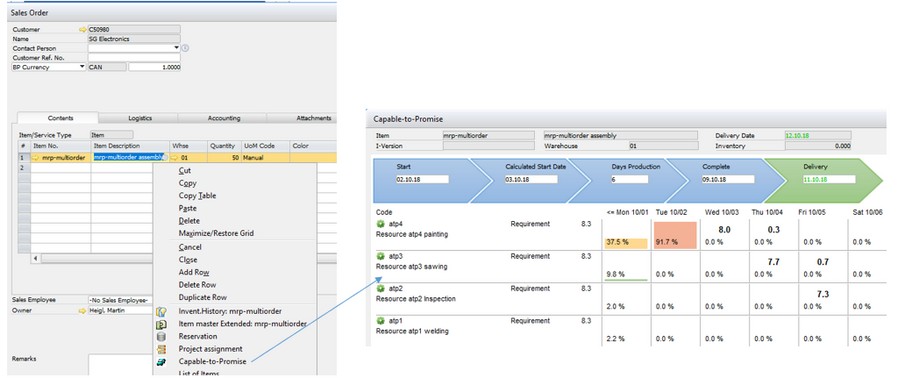

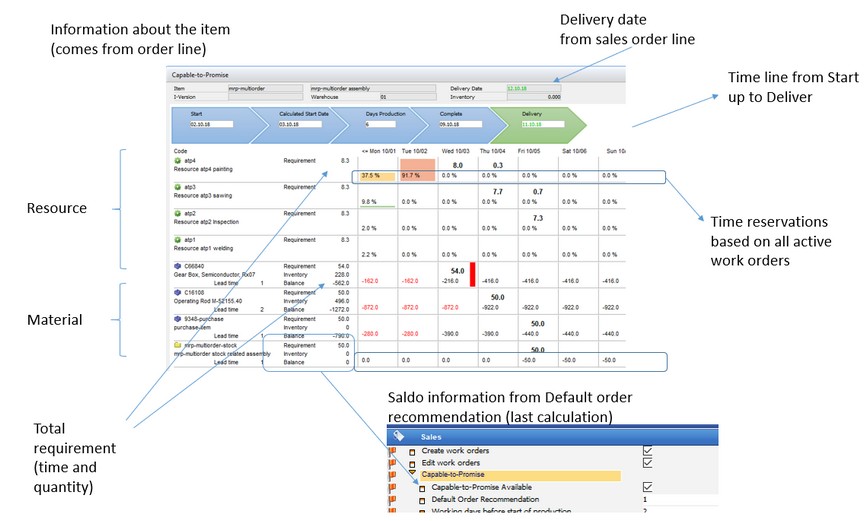

Resource View in CTP

Material consideration
The CTP takes the availability of the material into account. The Reference is the result of the last material requirements calculation of the MRP definition stored in the CTP.
Depending on the MRP definition, sales orders and forecasts are taken into account. You can use the same MRP as the reference that is used in the item history.

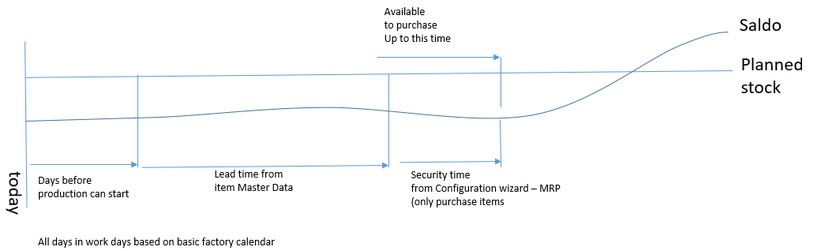

If an Item (Material or stock-based assembly) is not available, the lead time stored in the item is used.


|
